SAP S/4HANA On-Prem AI Connector Architecture for PM, QM and MM

By lamine yamal on May 13, 2026

sap-s4hana-on-prem-connector-pm-qm-mm

BAPI, IDoc, and OData calls are only the transport — what plants actually want from a SAP S/4HANA connector is module-specific intelligence on top. This guide covers iFactory's pre-built connectors for the three SAP modules that drive the most plant value: Plant Maintenance (PM), Quality Management (QM), and Materials Management (MM). For each, you will see the data objects, the AI use cases, the typical RFC and BAPI calls, and the outcomes that justify the integration. Production-tested on S/4HANA on-prem and S/4HANA Private Cloud through release 2023 and 2024.

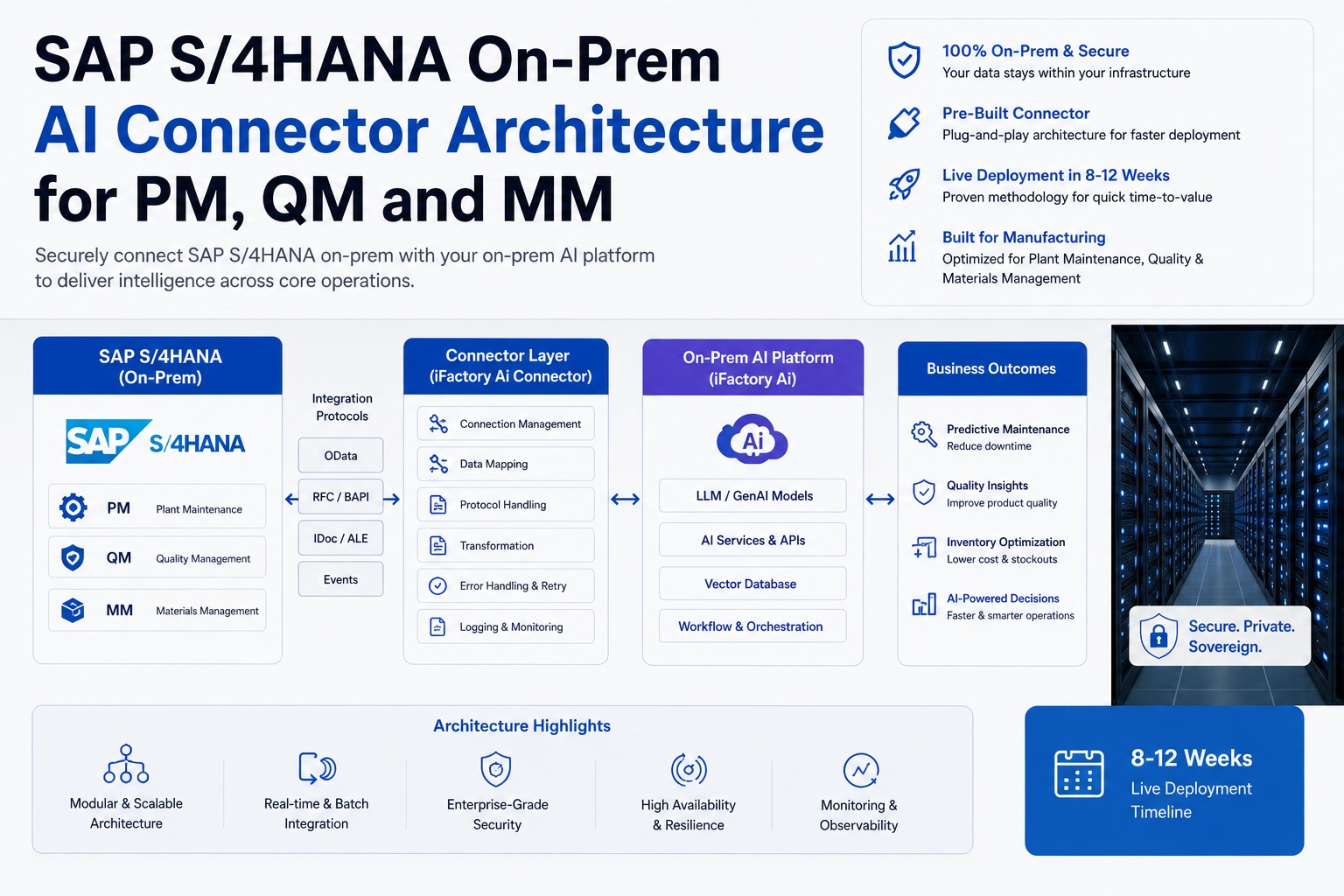

S/4HANA Connector Architecture

SAP S/4HANA On-Prem AI Connector Architecture for PM, QM and MM

Three SAP modules. One connector layer. Pre-configured for S/4HANA on-prem and S/4HANA Private Cloud. Each module ships with module-specific BAPIs, IDocs, OData services, and AI playbooks — production-tested, upgrade-safe, and live in 8–12 weeks.

SAP PM

Plant Maintenance

Equipment master · Functional locations · Work orders · Notifications · Maintenance plans

AI auto-creates WOs from PdM predictions
SAP QM

Quality Management

Inspection plans · Master inspection characteristics · Lots · Usage decisions · Q-notifications

AI vision auto-logs defects with annotated images
SAP MM

Materials Management

Material master · BOMs · Purchase orders · Goods movements · aATP · Source lists

AI triggers auto-PO on predictive stockout

What You Get — Turnkey S/4HANA Module Connectors

Pre-built. Pre-tested. Pre-loaded on NVIDIA DGX. Three modules, one ship, one go-live. No middleware tax.

Hardware

NVIDIA DGX, pre-racked, pre-cabled, ships ready to plug in.

Module Connectors

PM, QM, MM connectors with all BAPIs and OData services pre-wired.

Training

Module-specific playbooks for Basis, operators, and supervisors.

Support

24×7 monitoring, S/4HANA release compatibility, SLA-backed uptime.

3
Modules covered out-of-the-box

2040
S/4HANA mainstream maintenance horizon

40
Char extended material number length

0
Custom ABAP required
SAP PM · WO Created
Priority 1
Work Order #4500001847
Equipment: CAPPER-03 · FL: PLANT-B/LINE-2

TriggerAI vibration alarm 14:22
Order TypePM02 — Breakdown
Notification100023487 (M1)
AssignedTech: Ramesh K.
Scheduled21:30 same day

Created via BAPI_ALM_ORDER_MAINTAIN · committed · audit logged in SM20
SAP PM

Plant Maintenance Connector

Every iFactory plant connector for SAP PM ships with the same goal — predictive maintenance signals trigger SAP-side work orders, with notifications, technician assignment, spares confirmation, and audit trail all happening through standard PM transactions. No custom Z-tables. No parallel maintenance system.

What the connector does

Reads equipment master, functional locations, maintenance plans, and PM notifications in real time. Writes notifications, work orders, confirmations, and measurement documents from AI predictions.

Key BAPIs & objects

BAPI_ALM_ORDER_MAINTAIN, BAPI_EQUI_GETLIST, BAPI_ALM_NOTIF_CREATE, BAPI_MEASUREM_CREATE — plus CDS view I_MaintenanceOrder for fast OData reads.

AI use cases

Predictive maintenance from sensor data, vibration anomaly detection, energy-driven scheduling, technician skill matching, and spares pre-staging from forecasted failure dates.

Typical outcome

45% reduction in unplanned downtime · 30% drop in emergency PM work orders · 2× faster MTTR via auto-assigned technicians and pre-confirmed spares.

SAP QM

Quality Management Connector

QM is where AI vision and SAP intersect most powerfully. iFactory's QM connector turns every camera-detected defect into a properly-coded inspection result with usage decision, q-notification, and full traceability — all inside SAP QM, not a parallel quality system that nobody trusts at audit time.

What the connector does

Reads inspection plans, master inspection characteristics (MICs), and inspection lots. Writes inspection results, usage decisions (UD), quality notifications, and defect catalog entries — with annotated AI vision images attached as DMS documents.

Key BAPIs & objects

BAPI_INSPLOT_GETLIST, BAPI_INSPLOT_USAGEDECISION, BAPI_QNOTIF_CREATEFROMDATA, BAPI_INSPOPER_RECORDRESULTS — plus IDoc QPGR05 for inspection result transfer.

AI use cases

Vision-based defect detection on lines, automatic UD with confidence scoring, audit-grade defect classification, GxP-compliant evidence packaging for regulated industries.

Typical outcome

30% defect reduction · 90% less manual inspection time · 100% audit-grade traceability with vision evidence attached to every q-notification.

SAP QM · UD Posted
Rejected
Inspection Lot 100087421
Material: COMP-204 · Batch: B-247

CharacteristicViscosity (visual + sensor)
Result4.2 (spec 3.6–3.9)
AI confidence97.4%
Usage decisionA2 — Rejected
Q-notification500001284 (Q3)
Evidence3 annotated images attached

Posted via BAPI_INSPLOT_USAGEDECISION · committed · DMS-linked
SAP MM · Auto-PO
Triggered
Purchase Order 4500009127
Material: CAP-CLOS-7B · Plant: 1000

Stockout forecast72 hours
Current stock14,200 EA
Avg daily use4,800 EA
Source listSupplier 100847
Quantity50,000 EA
Lead time5 days · before stockout

Created via BAPI_PO_CREATE1 · aATP-checked · source list compliant
SAP MM

Materials Management Connector

MM is the connector that pays for the whole project. AI sees the consumption trends the planners miss, predicts the stockouts they will not catch in time, and triggers source-list-compliant POs before production ever pauses. Every transaction goes through SAP's aATP and procurement governance — no shadow purchasing.

What the connector does

Reads material master, BOMs, source lists, info records, vendor master, and live stock levels via aATP. Writes purchase orders, goods movements, reservations, and STOs — always honoring source list policy and approval hierarchies.

Key BAPIs & objects

BAPI_PO_CREATE1, BAPI_GOODSMVT_CREATE, BAPI_MATERIAL_AVAILABILITY, BAPI_RESERVATION_CREATE1 — plus aATP service API_PRODUCT_AVAILABILITY_SRV.

AI use cases

Demand sensing from POS or shop-floor consumption, predictive stockout alerts, dynamic safety stock, supplier risk scoring, and goods movement auto-posting from sensor-confirmed throughput.

Typical outcome

$2.3M average 3-year inventory cost reduction per plant · 80% drop in emergency POs · 25% improvement in fill rate without raising safety stock.

Connector Architecture

How Data Flows — Top to Bottom, Both Directions

One pipeline. Bidirectional. Every transaction observable at every layer. The vertical view below is exactly how the connector sits between your S/4HANA system and the iFactory AI brain.

Layer 1

SAP S/4HANA

System of record. Source of truth for PM equipment, QM lots, MM materials. Reads via OData CDS views; writes via BAPI through bgRFC destination.

Layer 2

iFactory Connector Layer

Module-specific adapters for PM, QM, MM. Handles authentication, transactional commits, retries, and protocol selection. Replaces SAP xMII for the on-prem AI use case.

Layer 3

Data Fabric

Time-series store, vector database, knowledge graph. Caches SAP master data for sub-second copilot queries. Buffers SAP writes if S/4HANA is briefly unavailable.

Layer 4

AI Brain — NVIDIA DGX

Best-in-class models — vision for QM, time-series for PM, foundation LLM for the copilot. Generates predictions, recommendations, and actions back into SAP.

Data Flow Patterns

Sync vs Async — Per Module Defaults

Each module has a default protocol pairing that reflects how plants actually use the data. These defaults are what ships out of the box — they are overridable but rarely need to be.

SAP PM
SYNC sRFC + BAPI

Real-time work order creation and notification posting. Operator expects an immediate SAP order number back. Latency budget — under 3 seconds.

ASYNC bgRFC + IDoc

Bulk measurement document uploads, shift-end equipment reading transfers. Eventual consistency is fine; throughput matters more than latency.

SAP QM
SYNC sRFC + BAPI

Usage decision posting must complete before the next pallet leaves the line. Latency budget — under 2 seconds, blocking on the conveyor signal.

ASYNC IDoc QPGR05

Inspection result bulk transfers at shift end. ALE-filtered to send only lots with results that need master data sync to other systems.

SAP MM
SYNC OData + aATP

Material availability checks during operator copilot queries. CDS view via OData hits S/4HANA in-memory column store. Latency budget — under 1 second.

ASYNC bgRFC queue

Goods movement bulk postings from auto-counted production. Throughput-optimized parallel queues prevent dialog work process exhaustion.

AI in Action

One Query, All Three Modules

The dialogue below shows a single operator question routing through PM, QM, and MM connectors in parallel — every fact grounded in live SAP transactions, every action written back through standard BAPIs.

PS
Production Supervisor · Voice
"Why is Line 2 running slow this morning and what should I do before the rejection rate climbs further?"
AI
iFactory Copilot · Grounded in SAP PM + QM + MM
Line 2 is running at 82% of target — three findings across three modules:

· SAP PM — Mixer #2 vibration trending high since 06:00; auto-created WO #4500001847 with priority 1, technician Ramesh assigned for 09:30
· SAP QM — Last 4 inspection lots show viscosity drift toward upper limit; AI vision confidence 94% on imminent spec breach within 2 lots
· SAP MM — Closure cap stock down to 9 hours at current run rate; auto-PO created via BAPI_PO_CREATE1, supplier 100847, lead time confirmed
PM · WOQM · visionMM · auto-PO
Deployment

The 8–12 Week Module Rollout Track

Reads first. Writes second. All three modules running concurrently — no waterfall, no waiting on one module to clear before the next begins.


1
Weeks 1–2

Provision & Read Paths

SAP service users, authorization objects, RFC destinations. PM equipment master + QM inspection plans + MM material master read paths live.

2
Weeks 3–6

Model Train & Pilot Reads

PdM models train on PM history. Vision models train on QM lots. Demand models train on MM consumption. Pilot copilot live on one line.

3
Weeks 7–10

Write Paths & Pilot Acts

BAPI write paths validated in sandbox. WOs, UDs, POs created in pilot scope. SM20 audit traces verified end-to-end.

4
Weeks 11–12

Plant Go-Live

Transport request promoted to production. All three modules live plant-wide. 24×7 monitoring active on all bgRFC queues and IDoc inboxes.

Outcomes

What Plants Measure After Module Go-Live

Aggregated from production deployments running the three-module connector on S/4HANA on-prem.

45%
Unplanned downtime reduction · PM
30%
Defect reduction · QM vision
$2.3M
3-year savings per plant · MM
Event · Orlando · May 13, 2026

See PM, QM, MM live at SAP Sapphire 2026

Live demo of the three-module connector running against S/4HANA — operator chat, auto-WO, AI-vision UD, predictive auto-PO. Book a 20-minute walkthrough.

Book the Walkthrough
FAQs

Frequently Asked Questions

Do I need to buy NVIDIA servers separately?

No. Fully-loaded NVIDIA DGX AI servers are supplied and installed as part of the iFactory package. They ship pre-racked, pre-cabled, with all NeMo, RAPIDS, NIM, and Agent Toolkit components pre-installed alongside the PM, QM, and MM connector library. You provide power and Ethernet. We provide the rest.

Which S/4HANA releases are supported?

S/4HANA 1809 through 2024, both on-premise and Private Cloud editions. The connectors handle the extended material number (40 chars), Universal Journal, and embedded analytics CDS views automatically. S/4HANA Cloud public edition is not the target — that environment requires SAP's own integration suite.

Can I deploy only one module instead of all three?

Yes. The most common starting point is PM-only — predictive maintenance gives the fastest payback. QM and MM are layered in during weeks 5–10 of the same deployment, but each is opt-in. The connector library is modular; you license what you use.

How does the connector handle S/4HANA Fiori & OData services?

Fiori UIs and iFactory copilots can coexist. The connector reads via the same OData services Fiori uses (CDS views on HANA's column store), so the data is consistent across both. AI predictions surface in the iFactory copilot; SAP transactions remain manageable via Fiori for users who prefer the standard UI.

What happens to an AI-created work order if a planner edits it in SAP?

SAP wins. The AI creates the WO with the data it had at creation time. Any subsequent planner edit in IW31 or Fiori takes precedence — the AI never overwrites a human-edited field unless the AI is explicitly granted update authority on that field. Audit log shows both the AI creation and the planner edit.

Can AI auto-post goods movements without operator approval?

Configurable per material group and per movement type. By default — automatic posting for sensor-confirmed movements with high AI confidence and low transaction value. Manual approval is required for high-value materials, regulated batches, or movements above a threshold. The threshold is set during the architecture review.

How is the connector audited?

Three audit layers. SAP-side — SM20 logs every service-user transaction. iFactory side — every AI prediction and resulting BAPI call is logged with timestamp, user, and confidence score. Combined — a single audit view joins both and is exportable for regulatory inspections.

Is the connector compatible with SAP DMC (Digital Manufacturing Cloud)?

Yes. iFactory can coexist with SAP DMC where DMC handles MES execution and iFactory handles AI. The two systems integrate at the SAP layer — DMC writes to S/4HANA via RFC, iFactory reads the resulting transactions via OData and writes its AI-driven outcomes via BAPI. No direct DMC-to-iFactory coupling needed.

Three Modules. One Connector. Live in 8–12 Weeks.

Plant Maintenance, Quality Management, and Materials Management — all wired to your S/4HANA system, all governed by your SAP authorization, all running on-prem on NVIDIA DGX. Pick one module to start or roll all three at once.

1000+ clients worldwide 99.9% uptime SLA SAP Certified Integration NVIDIA DGX Partner
