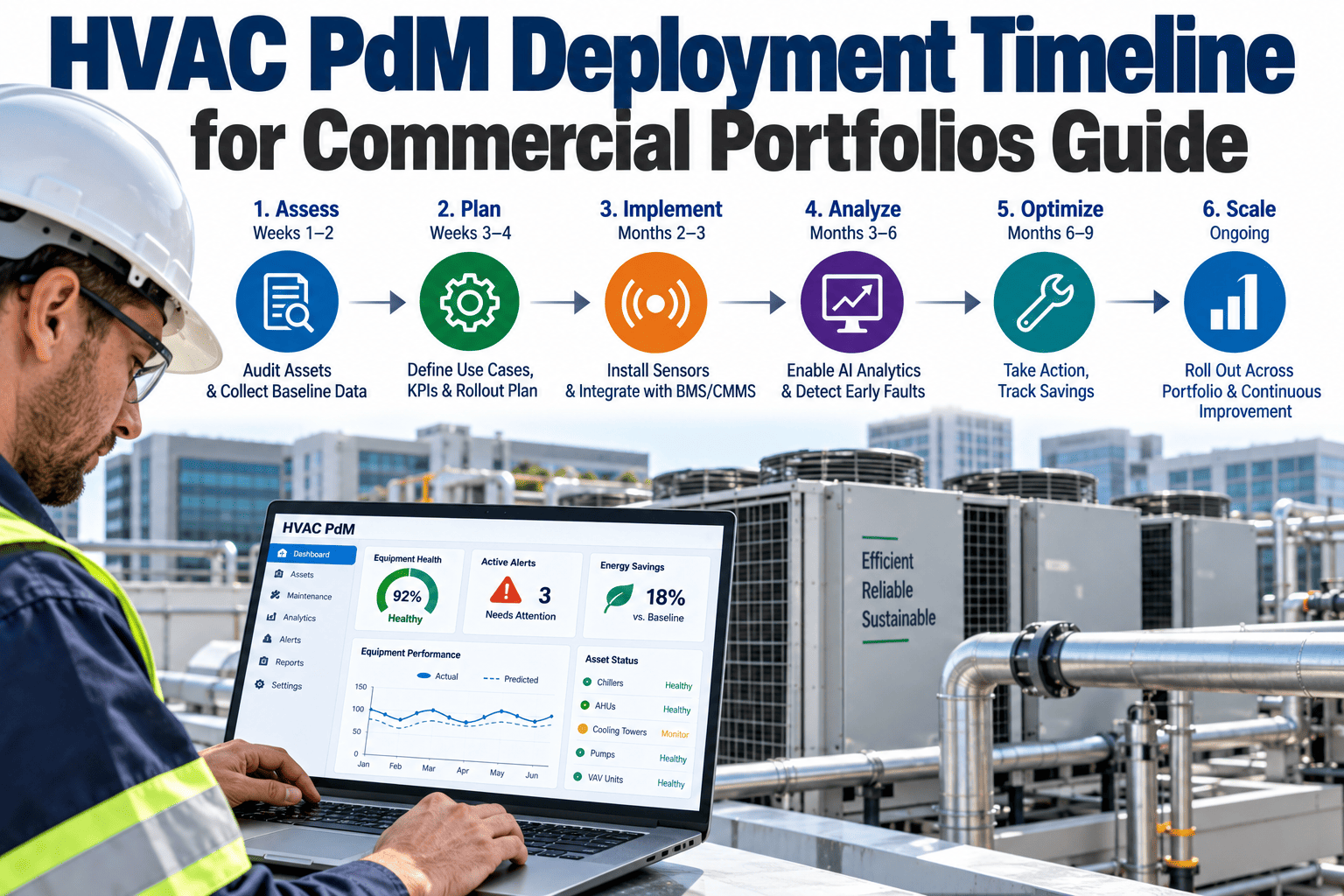

HVAC PdM Deployment Timeline for Commercial Portfolios Guide

By James Smith on September 14, 2026

hvac-pdm-deployment-timeline-for-commercial-portfolios-guide

A striking share of AI maintenance pilots never make it to production, and the reason is almost never that the algorithm didn't work. It's that the rollout skipped the structured sequence that turns a proof of concept into a program — instrumenting every building at once instead of proving value on one, training a model on six weeks of data and expecting it to predict a failure it's never seen, or discovering three months in that the sensors, the BAS, and the CMMS were never actually built to talk to each other. A portfolio-wide HVAC PdM deployment succeeds or stalls based on how deliberately those phases are sequenced, not on how sophisticated the underlying AI is. iFactory structures the rollout as a pilot building, a defined expansion phase, and a full-portfolio scale-up, each with gating criteria that have to be met before moving to the next — see a realistic timeline built against your own portfolio.

P2 · HVAC PREDICTIVE MAINTENANCE · PORTFOLIO DEPLOYMENT TIMELINE

Most PdM Programs Don't Fail on the Algorithm. They Fail on the Rollout.

A pilot proven on one building, an expansion phase that stress-tests the process, and a full-portfolio rollout that scales what already worked — iFactory sequences HVAC PdM deployment with real gating criteria at each stage, not a single big-bang launch.

WHY ROLLOUTS STALL

The Deployment Mistakes That Have Nothing to Do With the AI

The same handful of failure patterns show up at portfolio after portfolio attempting to move from reactive HVAC maintenance to predictive, and almost all of them are organizational and sequencing mistakes rather than technology gaps.

Instrumenting Everything at Once
Connecting every building in the portfolio simultaneously multiplies cost, complexity, and the number of integration problems that can surface before anyone has proven the approach delivers value anywhere.
Expecting Instant Predictions
A model asked to flag failures before it has seen normal operating conditions across a full seasonal cycle produces noise, not insight — the baseline period isn't optional overhead, it's what makes the predictions trustworthy.
Assuming Systems Already Talk to Each Other
A BAS, a CMMS, and a monitoring platform that were never built to integrate don't start cooperating just because a PdM project is now depending on them to.

None of these mistakes are unique to HVAC — the same pattern derails predictive maintenance programs across industrial plants, aviation fleets, and commercial buildings alike. What's specific to a commercial real estate portfolio is the scale of the fix: dozens or hundreds of buildings, each with its own BAS vintage, its own equipment mix, and its own operating team, all of which the rollout sequence has to account for.

What tends to compound these mistakes on a real estate portfolio specifically is organizational pressure that doesn't exist the same way in a single industrial plant. A portfolio manager reporting to an investment committee wants to show progress across the whole footprint quickly, which creates exactly the incentive to skip a phase or compress a baseline period that a deliberate rollout is designed to resist.

THE THREE PHASES

Pilot, Expansion, Full Portfolio — What Each One Is Actually For

Each phase of the rollout exists to answer a specific question before the next phase commits more capital and more operational disruption to the answer. Skipping a phase, or treating all three as one continuous rollout, is where most of the risk in a portfolio deployment actually lives.

Pilot Building Does the approach work at all? Expansion Phase Does the process hold under variety? Full Portfolio Does it scale without re-proving each time? Gate 1 Gate 2 each gate must pass before the next phase begins
PHASE 1
Pilot Building
One building, a small set of critical assets, one clear success metric. The pilot exists to prove the detection works and the workflow is usable — not to deliver portfolio-wide ROI yet.
PHASE 2
Expansion Phase
A handful of additional buildings chosen for variety — different BAS platforms, different equipment ages, different operating teams — to confirm the pilot's success wasn't a fluke of one favorable site.
PHASE 3
Full Portfolio Rollout
Systematic scale-up across every remaining building, using the models, thresholds, and integration patterns proven in the first two phases rather than re-proving the approach at every new site.

See a phased rollout plan built around your portfolio

iFactory can recommend the right pilot buildings and a realistic timeline for your specific portfolio, before you commit to anything.

GATING CRITERIA

What Actually Has to Be True Before Advancing

A gate isn't a calendar date, it's a specific, measurable condition that has to be satisfied before the next phase begins — advancing on a schedule rather than on evidence is exactly how a portfolio ends up scaling a program that hasn't actually been proven.

Gate What Must Be True Why It Matters
Pilot → Expansion Baseline data covers a full seasonal cycle; at least one predicted fault confirmed against an actual repair Confirms the model's predictions are grounded in real failure behavior, not just plausible-looking noise
Pilot → Expansion Work orders generated from alerts are actually being actioned by the maintenance team A technically accurate prediction that nobody acts on delivers zero operational value
Expansion → Full Rollout The integration pattern works across at least two different BAS platforms or vendor mixes Confirms the pilot's success wasn't dependent on one building's unusually clean system setup
Expansion → Full Rollout Model thresholds transfer to equivalent equipment with acceptable false-alert rates Verifies the detection logic generalizes rather than being overfit to the pilot building's specific quirks

These gates exist to catch exactly the failure pattern that derails most programs — advancing on optimism rather than evidence, and discovering the gap only once the full portfolio budget is already committed.

It's worth being explicit that a gate is a pass or investigate decision, not an automatic pass or fail. A pilot that falls short of a threshold usually points to something specific and fixable — an integration gap, a threshold that needs recalibrating, a workflow step the maintenance team isn't following — rather than evidence the whole approach doesn't work. The gate's value is in forcing that investigation before more capital is committed, not in being a strict cutoff.

REALISTIC WEEKS

What Each Phase Actually Takes

Facilities teams under pressure to show results often compress the timeline in the pitch even when the underlying work can't compress with it. Here's what each phase realistically requires when done in the right order.

1
Weeks 1-4: Ground the Pilot
Select the pilot building and its critical assets, install the pre-configured server, connect the BAS, and begin baseline data collection.
2
Weeks 5-12: Collect the Baseline
Normal operating data accumulates across enough of the seasonal cycle to give the model a genuine picture of what typical performance looks like, not just a few weeks of one season.
3
Months 3-6: Validate the Pilot
The model runs live, predictions are checked against actual outcomes, and the work order workflow is proven to actually get used by the maintenance team before the first gate is evaluated.
4
Months 6-12: Expand and Confirm
Additional buildings with different BAS platforms and equipment mixes are brought on, testing whether the pilot's success generalizes before the second gate clears.
5
Month 12+: Scale the Portfolio
Remaining buildings are onboarded systematically using the proven models and integration patterns, with new sites moving through a lighter-weight version of the same process rather than starting from scratch.

Compressing this timeline doesn't actually save time, it just moves the risk downstream — a portfolio that skips the baseline period or advances past a gate on hope rather than evidence tends to discover the gap during full rollout, which is the most expensive place for it to surface.

Seasonal coverage in particular is not a step that can be shortcut by throwing more resources at it. A building's HVAC load in July looks nothing like its load in January, and a model trained only on summer data has never seen how the system behaves under a winter heating cycle — no amount of additional computing power changes the fact that the calendar has to actually pass for that data to exist.

WHY THE PILOT BUILDING MATTERS

Choosing the Right First Building, Not the Convenient One

The instinct is often to pilot in whichever building is easiest to access or has the friendliest facilities team, but that's frequently the wrong choice — the pilot exists to prove something specific, and an unrepresentative building proves the wrong thing.

Pick for Representativeness, Not Convenience
A pilot building with a typical BAS vintage and a typical equipment mix for your portfolio produces results that actually predict how the rest of the portfolio will behave.
Choose Assets by Failure Cost, Not Ease
The three to five critical assets selected for the pilot should be the ones where an unplanned failure carries the highest cost and disruption, not simply the ones easiest to instrument.
Involve the Team That Will Scale It
The facilities and maintenance staff who'll be running the program at full portfolio scale need to be part of the pilot, not brought in cold once the rollout decision is already made.
Define Success Before Starting
A single, clear success metric agreed before the pilot begins prevents the goalposts from shifting once results start coming in — whether favorable or disappointing.

A pilot chosen for convenience can look successful and still fail to predict how the approach performs on the harder buildings in the portfolio, which is exactly the gap that shows up expensively once full rollout begins.

There's a temptation to pilot in the newest, best-instrumented building in the portfolio because it's the easiest place to get a clean result quickly. That instinct produces a pilot that proves the technology works under ideal conditions, which is a different and less useful question than whether it works on the twenty-year-old building with a legacy BAS that represents most of the actual portfolio.

TURNKEY DELIVERY

Delivered as a Phased Program, Not a Single Installation

iFactory's HVAC PdM deployment is structured around this same pilot-expansion-rollout sequence from the start, so the gating criteria are built into the engagement rather than left to your team to define and enforce.

What Arrives
A pre-configured NVIDIA AI server, racked and ready, with the PdM software already loaded for the pilot building
Rack it, connect power and Ethernet, and the AI is live on your network
A defined success metric and gating criteria agreed before the pilot begins
A model architecture built to transfer to equivalent equipment across the portfolio
24×7 remote monitoring throughout every phase of the rollout
The Full Timeline
Pilot (Months 1-6): One building, baseline collection through a seasonal cycle, validated predictions, gate evaluation.
Expansion (Months 6-12): Additional buildings across different BAS platforms, confirming the pattern generalizes.
Full Rollout (Month 12+): Systematic onboarding across the remaining portfolio using proven models.

Scope covers the cabling, network configuration, BAS integration, and staff training at each phase, so what your team gets is a program built to scale from the outset rather than a pilot that has to be re-architected once portfolio-wide rollout is approved. Trusted by 1000+ clients with 99.9% uptime, the deployment is built to fit around a live, occupied portfolio.

That distinction — built to scale versus rebuilt to scale — is where a surprising amount of wasted effort in industry-wide PdM rollouts actually originates. A pilot architected as a one-off proof of concept, with integration choices and data structures specific to that single building, routinely has to be substantially reworked before it can support a second site, let alone a hundred. Designing for the eventual portfolio scale from day one avoids paying for that rework twice.

FREQUENTLY ASKED QUESTIONS

What Portfolio Teams Ask Before Starting a Rollout

Can we skip the pilot and go straight to a handful of buildings if we're confident the approach will work?
You can, but it removes the specific safeguard the pilot phase is designed to provide — a controlled environment where the first integration problems, the first model calibration issues, and the first workflow gaps surface on one building instead of several simultaneously. Confidence in the technology isn't the same as confidence in how it will integrate with your specific BAS, your specific maintenance team's workflow, and your specific building's equipment history, which is exactly what the pilot is built to test cheaply before it's tested expensively. Talk through the tradeoffs for your specific situation before you commit to anything.
How do we pick which building should be the pilot?
The right pilot building is representative of your broader portfolio's BAS vintage and equipment mix, not simply the easiest one to access or the one with the most cooperative facilities team — a pilot that succeeds on an unusually favorable site tells you little about how the rest of the portfolio will perform. Critical assets within that building should be chosen by failure cost and disruption impact, not by ease of instrumentation. Our team can help evaluate candidate buildings against your portfolio's actual variety.
What happens if the pilot doesn't clear its gate?
That's a legitimate and useful outcome, not a failure of the program — a pilot that doesn't clear its gate has done exactly what a pilot is supposed to do, which is surface a problem while the cost of fixing it is still contained to one building rather than discovered mid-rollout across dozens. The gate criteria exist precisely so that "the pilot didn't work" is information you get early and cheaply, and the response is usually a targeted fix and a re-evaluation, not an abandonment of the whole approach. See how gate failures are typically resolved in practice.
Does the whole 12+ month timeline mean we won't see any value until full rollout?
No — the pilot building itself starts generating value as soon as predictions are validated and work orders are being actioned, typically well before the six-month mark, and the expansion-phase buildings begin producing their own value as they come online rather than waiting for the entire portfolio to finish. The full 12+ month figure describes when the complete portfolio is covered, not when the program starts paying for itself. Get a realistic value timeline for your specific portfolio size.
Can the expansion and full-rollout phases move faster than the pilot did?
Generally yes, and that's part of the point of proving the approach in phases — once the model architecture, integration pattern, and workflow are validated in the pilot, onboarding an equivalent building in the expansion or full-rollout phase is a lighter-weight process than the original pilot, since much of what had to be discovered the first time is now known. The baseline data collection period doesn't disappear entirely for a new building, but the surrounding validation work shrinks substantially. Our team can estimate the pace for your specific portfolio once the pilot clears.
PROVE IT ONCE, SCALE IT DELIBERATELY

Deploy HVAC PdM the Way Programs That Actually Reach Full Scale Do

iFactory sequences the rollout as a pilot building, a tested expansion phase, and a systematic full-portfolio scale-up — with real gating criteria at every step, not a single big-bang launch.
